Project Management is a vital skill for a senior packaging technologist or development manager. This page outlines my approach and gives some examples of the skills I've acquired to fulfill this role.

Typically a project will have five phases:

  • Ideas phase - Ideas for new or improved packaging
  • Feasibility phase - Costs, mock-ups, supplier briefs, laboratory and small scale line trials
  • Capability phase - Refining costs, production and distribution trials, trade informed, technical drawings and artwork
  • Launch phase - Finalising costs, production and distribution trials
  • Post-Launch review - anything learned to apply to the next project

Gantt charts listing tasks, milestones and resources (See example project plan below)

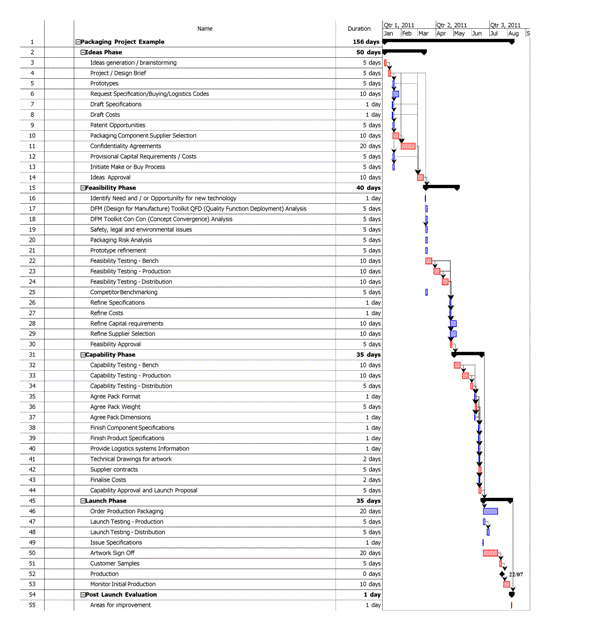

Example of Packaging Project Plan

Stakeholder Analysis

  • Identify all those with an interest in the project, this group would typically include:
    • Technical (packaging development, product development and project engineering)
    • Packaging supplier (sales, technical, planning, production and artwork)
    • Production (line operators, factory engineers, planners)
    • Marketing and Sales (including contact with customers and design agencies)

Risk Analysis:

  • Follow the supply chain from packaging raw materials to the consumer identifying possible risks, their likelihood and impact
  • Rate the risks and focus on those with a high likelihood and high impact (See example below)

    Supply Chain Analysis

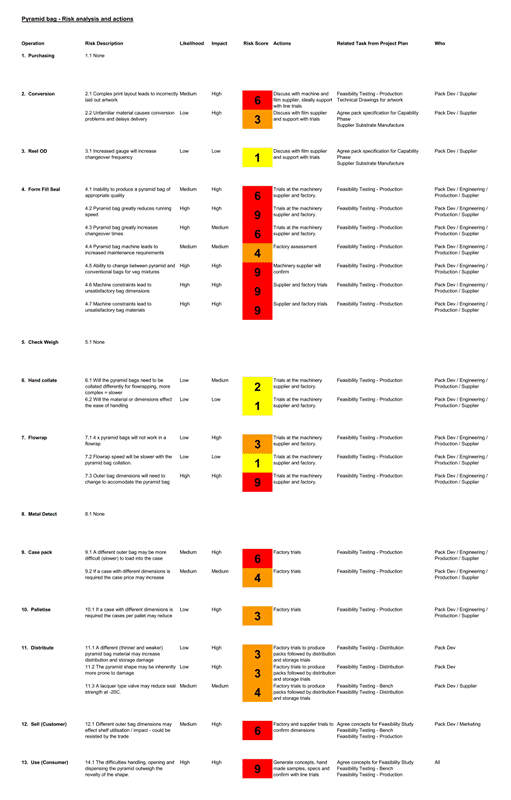

    Risk Likelihood and Impact Analysis

Commercial viability:

  • Packaging components and machinery costs
  • Packaging line efficiency costs

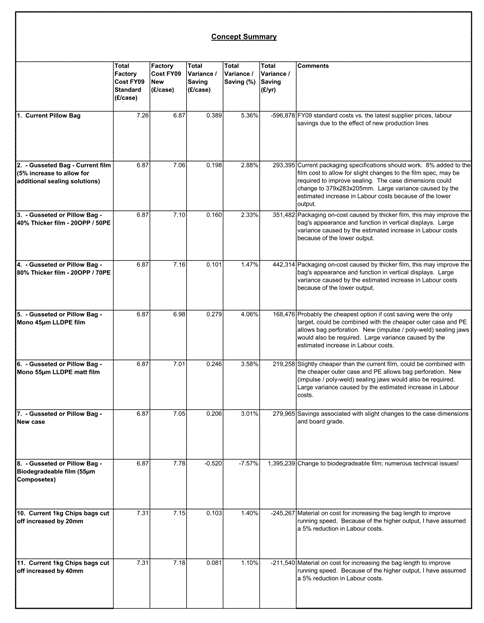

  • Concept Cost Comparison
